Using tokens to allocate time in Scrum at Caktus

In January of 2016, Caktus transitioned from a general Agile development environment to a more focused Scrum environment. Part of this transition entailed moving from a targeted budget allocation approach per project, to a self-organizing, goal-based team structure with no obvious provision for tight, consistent control over project budgets.

If managing budgets is part of your job, you can appreciate how much our project managers struggled with this. We shifted to working in 2-week-long goal-based sprints, but still had to pay attention to budget constraints. We searched for a way to still effectively manage our budgets, but to do so without exercising unseemly amounts of un-Scrum-like “command and control”.

We also noticed that the development team members were having their share of budget-related struggles:

  • If we didn’t discuss hourly budgets in sprint planning, it was difficult for team members to gauge whether the stories they were committing to aligned both with the sprint goals and the project budgets.
  • However, if we did discuss hourly budgets in sprint planning, the teams tended to feel a lack of agency, which inhibited self-organization. This also tended to introduce an unwanted comparison of hours to story points.
  • It was common for the team to commit to stories that appeared to meet the sprint goals, and not realize until the end of the sprint that multiple team members had over-focused on the same project during the sprint. This could lead to overspending on some projects, while underspending on others.
  • The teams realized that without increased transparency regarding budgets, it was entirely possible for them to deliver sprint goals and satisfy client needs, but still come in over- or under-budget.

So how do we maintain our project budgets, empower the team, be truly Agile, and still deliver a working product at the end of each sprint that meets the goals?

Tokens!

Here’s our solution:

  1. Acquire supplies: colored tokens, large pads of paper, markers.

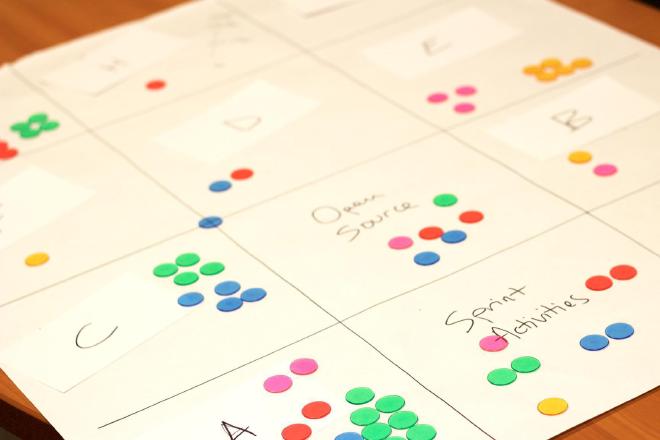

  2. Create a grid on a large piece of paper with enough boxes for your team’s budget sources. These can be projects, sprint activities, time off, etc., but should reflect the main buckets of time that your team members allocate to during sprints. Label each box.
  3. Designate a budget for each token to represent. Our tokens each represent 1 half day (or 4 hours).
  4. During sprint planning, each team member selects a color and takes the amount of tokens equal to their availability during the sprint. Full-time team members at Caktus get 20 tokens; part-time members take fewer as appropriate.
  5. Team members then allocate their tokens in the boxes as they see fit. At this time, the Product Owner (PO) can communicate any budget limitations for specific projects. The team resolves allocation conflicts amongst themselves.

This exercise helps the team identify and resolve these frequent conflicts:

  • Sprint goals not achievable within the budget
  • Over- or under-allocation by individual team members, due to PTO, enthusiasm, or other commitments
  • Project favoritism (everyone wants to work on one project)
  • Project only gets time from a single team member, leaving no space for pull request review or quality assurance from the rest of the team

Typically, our project managers (playing the role of Product Owner) go over the sprint goals prior to this exercise. Once the initial allocation is complete, the team progresses to planning their sprint, starting with the token exercise. This usually takes no more than 5-10 minutes. The grid with the tokens is left in play through the end of the sprint, allowing team members to reference and adjust it as needed. After sprint planning, the Scrum Master posts the initial allocations to the team’s Basecamp.

The budget allocations per person that come out of this exercise are not communicated to the team again during the sprint by the PO, Scrum Master, or other stakeholders. The team can choose to reference the allocations or not, as they see fit. If desired, the PO can compare the initial allocation data to the actual expenditures after the sprint ends. This type of comparison over multiple sprints can be useful in identifying trends that the PO can act upon. For example, if a project is consistently allocated more time in sprint planning than is actually spent on it, yet the goals are always completed, this could be an indication that the goals and/or stories for that project are too small and can be increased in scope.

All three of our Scrum teams are choosing to use this exercise for now. We’ve found that the token exercise provides budget transparency for the development teams, a mechanism for hourly budget management (without command and control) for the POs, and a starting point for team conversations about resource allocation. It also starts sprint planning with a hands-on activity that gets the team thinking and moving around.
